Projects & Bids
To submit a bid proposal or to review current requests for proposals, visit the Quest Construction Data Network site.2026
W. Wisconsin Avenue Utility and Street Reconstruction Project: Burroughs Dr to Ryan St:
Project Substantial Completion: October 9, 2026
Project Final completion: October 15, 2026
Click Here to View Project Plans and Detour Information

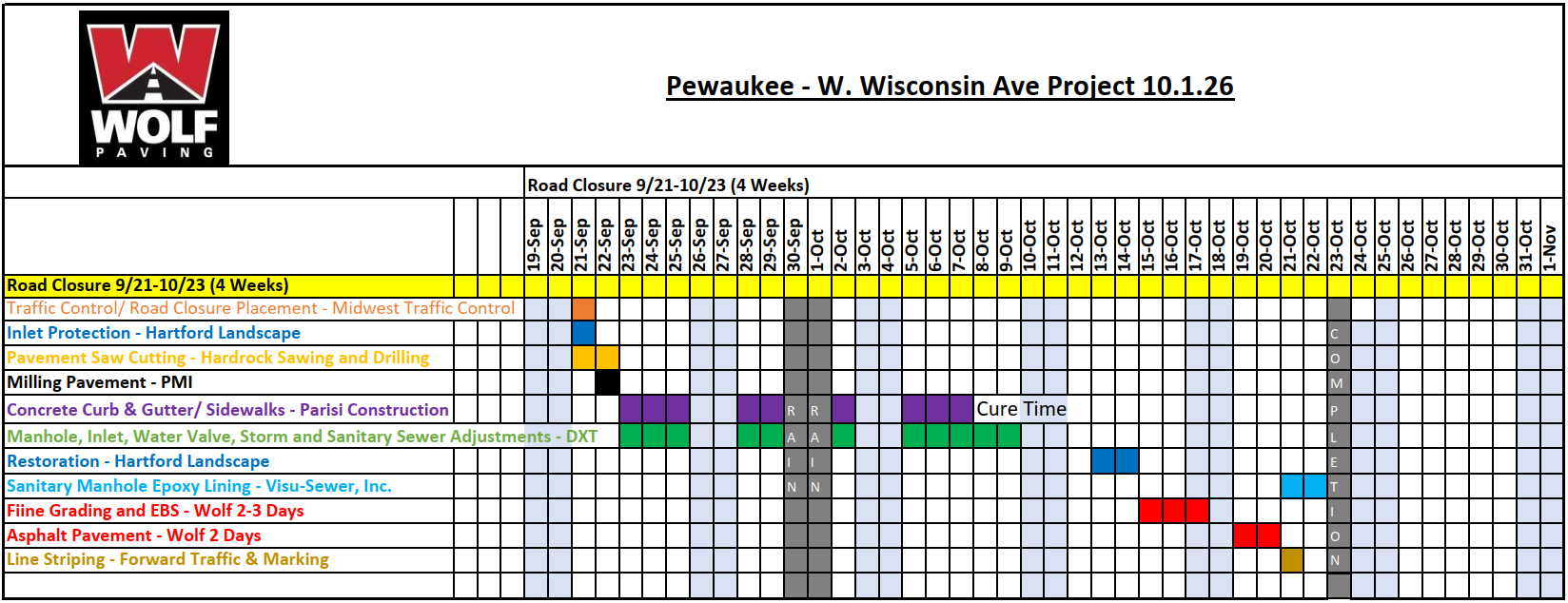

10.05 to 10.10.2026 Update:
09.25 to 10.02.2026 Update:
Utility work will continue today (09/25) with curb inlet adjustments and repairs being completed. Mon or Tuesday (09/28-09/29), Wolf will be removing the ramps and asphalt around manholes and fixing any driveway ramps that need adjustment from traffic. Wed-Friday (09/30-10/02), DXT will be working on manhole adjustments. Thurs-Friday (10/01-10/02) Parisi will also be there forming for concrete curb and walks.
09.17.2026 Update:
The Village’s repaving project for W. Wisconsin Avenue from Burroughs Drive to Glacier Road will start Monday, September 21. There will also be some spot concrete sidewalk panel removal and replacement in the Park Hills Subdivision and along the sidewalk at the lakefront. The work includes spot concrete curb and gutter removal and replacement, storm sewer structure repair, water valve box replacement, ADA sidewalk ramp removal and replacement, pavement removal and replacement, pavement striping, sanitary sewer manhole lining, and traffic control and detour signage. Street and utility reconstruction is a major undertaking. We appreciate your tolerance to the noise, dust, dirt, mud, potential temporary water outages, and the overall inconvenience of reconstruction. During the project, a construction inspector will be onsite to observe construction. You may contact this inspector if you have comments, questions, or concerns with the project. If you have any questions concerning this project or its effect on your property, please also call (262) 691-5694 or email dbuechl@villageofpewaukeewi.gov.
07.24.2026 Update:
W. Wisconsin Avenue, is planned to be reconstructed as part of the Village’s 2026 Street Program. The W. Wisconsin Avenue project will extend from Burroughs Drive to Ryan Street. The work is anticipated to start in early-September and planned to be completed by end of October, 2026. The Contractor for this project has not yet been determined. This project is a continuation from where last year’s W. Wisconsin Avenue project ended. Earlier this summer, Glacier Road was reconstructed as part of a separate project. Along W. Wisconsin Avenue, the work includes spot concrete curb and gutter removal and replacement, storm sewer structure repair, water valve box replacement, ADA sidewalk ramp removal and replacement, pavement removal and replacement, pavement striping, sanitary sewer manhole lining, and traffic control and detour signage. This W. Wisconsin Avenue project is a Village funded project. If your property adjoins sidewalk that has defects such as cracks, missing pieces, or differential settlement of panels, there are planned sidewalk assessments to property owners in accordance with Village Ordinance. During the project, a construction inspector will be onsite to observe construction. You may contact this inspector if you have comments, questions, or concerns with the project.
Parking and Access
Once the Village receives the schedule from the Contractor the start date for the project will be posted to the Village of Pewaukee website. Before actual construction starts, the Contractor will be issuing a notice 24-hours in advance to properties along the construction work. After that notice, the utility and street work will begin. Local traffic for property owners within the work zone will attempt to be maintained as much as possible during the construction. There may be intermittent times when no access will be allowed depending on what work is being completed, or a short wait will needed to allow the contractor to finish a portion of work before allowing vehicle access. Please observe “No Parking” signs to assist the Contractor in getting the work completed.
During the project, local traffic from within the construction zone will have access to their driveways. There will be temporarily no access across your driveway while your driveway is being removed and replaced, or if street or pipe work is being completed immediately in front of your driveway. This W. Wisconsin Avenue project is planned to include a Detour Plan to route traffic from outside the construction zone around the project to attempt to minimize traffic so the contractor can more efficiently complete the work. The Detour Plan is subject to being continually agreeable to the Wisconsin Department of Transportation and Waukesha County.
Water main valve replacement
The 8-inch PVC main was relayed in 2002 so this pipe will remain as is. Ten water main valves have broken stems and will be replaced on the water main. No water service outages are planned to complete this work. During construction, unplanned events can occur such as water main breaks, damaged pipes, or unexpected discovery of non-operating water valves which can cause unplanned water outages.
Sanitary Sewer Manhole Lining
Several sanitary sewer manholes will be lined as part of this project due to deterioration of concrete from hydrogen sulfide gas.
Street Reconstruction
The existing street width will remain the same. The plan is to preserve as much concrete curb and gutter as possible. The Contractor will attempt to not disturb fences or retaining walls that are located adjacent to the right of way line near sidewalk ramp replacements at intersections. If you have any plantings or landscaping that you want to preemptively re-plant please have them removed before the construction begins. Also, you may trim any limbs or bushes that overhang the street. The Contractor will not be responsible for broken branches that overhang into the street.
Please do not drive on the new pavement until the barricades have been removed from the entrances. The new street will be opened as soon as possible. Concrete sidewalk replacements will require a one-week cure time. During that time, residents will not be able to traverse the newly poured concrete sidewalk. After the street is open, there may be seeding and miscellaneous work to finish. The schedule of this project will depend greatly upon the weather.
Garbage and Recycling
During the street reconstruction, garbage and recycling collection will continue on the same day that it is usually collected. Your carts may need to be moved to the end of the street if the garbage truck driver determines he or she cannot drive through the construction project.
Street and utility reconstruction is a major undertaking. We appreciate your tolerance to the noise, dust, dirt, mud, temporary water outages, and the overall inconvenience of reconstruction.
If you are a business owner with employees or customers, property manager or landlord and your property is rented to tenants, please pass along the applicable information to your employees, customers, or tenants as soon as possible. If you have any planned projects, or deliveries, please take into consideration the upcoming project.
If you have any questions concerning this project or its effect on your property, please call (262) 691-5694 or email dbuechl@villageofpewaukeewi.gov.
Nighttime railroad work to take place in Pewaukee, Nashotah, Oconomowoc, and Watertown:
KANSAS CITY, Mo. – Canadian Pacific Kansas City Railway crews will work overnights replacing ties on the rail corridor parallel to Wisconsin State Highway 16 starting Monday, April 20. Residents in Pewaukee, Nashotah, Oconomowoc, Ixonia, Watertown, and surrounding areas should expect extra noise and lights until work is completed, likely in mid-June.
Crews will use mechanized track machinery to replace ties that are approaching the ends of their useful service lives from 5 p.m. until 3 a.m. Monday-Thursday nights, finishing for the week early on Fridays. The work supports safe train operations on CPKC’s busy Twin Cities-Chicago rail corridor. Nighttime work is necessary to avoid delaying Amtrak’s Borealis and Empire Builder services, which use the CPKC line, in addition to minimizing freight disruptions. Work will begin at Pewaukee and progress westward, finishing in Watertown over the course of 6-8 weeks.
CPKC engineering personnel will coordinate crossing removals with local road authorities and private crossing owners. All crossings will be removed and reinstalled, which should improve road surface conditions.
Public Service Announcement
Glacier Road Street and Utility Reconstruction Project:
07.16 to 07.17.2026 Update: The contractor is stoning the road shoulders, completing turf restoration, and test and sealing sanitary sewer lateral connections.
07.09.2026 Update:
Glacier Road will be asphalt paved on Friday, July 10, 2026 starting at 6am. There will be intermittent times when vehicles will not be able to pass but the crews will work quickly to try and get vehicles to be able to pass as soon as the road is ready to drive on.
06.01 to 06.05.2026 Update:
Monday – complete water services
Tuesday to Wednesday – sanitary lateral repair (just west of Kopmeier)
Thursday to Friday – sanitary main repair (just east of Carlee’s) and potentially Butler Inn water connection
Busing can continue with normal route operations. The crew will make sure the bus can maneuver through the site.
05.25 to 05.29.2026 Update:
Water services to houses will continue.
05.11 to 05.15.2026 Update:
The crew will be performing culvert remove and replacements and a sanitary repair, all of this work will be from west end to just west of Kopmeier. Crew will also be testing the water main and if all goes well towards the end of the week they may be installing water services.
Buses will be able to access from both west and east ends except for sanitary repair which is in center of roadway. The Village will be notified on the day this will occur. Kopmeier traffic will be able to exit to the east and Glacier to the west.
The short intersection detour (red line) will be removed Saturday and intersection will be accessible however a portion will be barreled off for water main testing protection.
05.04 to 05.08.2026 Update:
Monday to Wednesday the crew will continue with water main installation and buses will be allowed to pass from the east and west. On Wednesday a subcontractor (Visu Sewer) will be onsite to clean and jet the sanitary sewer, they are also aware of busing situation and will allow buses through.
Starting Thursday morning (05/07) the Wisconsin/Glacier intersection detour will be posted to allow the crew to install the water in Wisconsin. This will continue Friday and by end of the day Friday the detour will be pulled. There will be modifications to the intersection after opening as a portion of the road will need to be closed to protect the water main testing equipment but traffic will be able to get through.
Thursday and Friday use short detour noted in red below. Buses will still be able to enter site from east or west but with use of short detour.

04.15.2026 Update:
The Glacier Road project will be from W. Wisconsin Avenue to the west for 1,160 feet to the Village limits. The work is anticipated to start in late April and planned to be completed by end of July, 2026. The Contractor for this project is DF Tomasini Contractors, Inc. Along Glacier Road, the work includes relay of the water main and water services, relay of storm sewer culverts, ditch grading, spot concrete curb and gutter removal and replacement, ADA sidewalk ramp removal and replacement, pavement removal and replacement, pavement striping, and sanitary sewer lining.
Later in the summer, the remainder of W. Wisconsin Avenue, is planned to be repaved from Burroughs Drive to Glacier Road as part of a separate project. During the project, a construction inspector will be onsite to observe construction. You may contact this inspector if you have comments, questions, or concerns with the project. Street and utility reconstruction is a major undertaking. We appreciate your tolerance to the noise, dust, dirt, mud, temporary water outages, and the overall inconvenience of reconstruction. If you have any comments, questions, or concerns, please Dave Buechl by calling (262) 691-5694 or via email dbuechl@villageofpewaukeewi.gov.
02.25.2026 Update:
The Glacier Road project will be from W. Wisconsin Avenue to the west for 1,160 feet to the Village limits. The project will be bid in March and work is anticipated to start in early-May and planned to be completed by end of July, 2026. The Contractor for this project has not yet been determined. The work includes relay of the water main and water services, relay of storm sewer culverts, ditch grading, spot concrete curb and gutter removal and replacement, ADA sidewalk ramp removal and replacement, pavement removal and replacement, pavement striping, and sanitary sewer lining.
2026 W. Wisconsin Avenue: the remainder of W. Wisconsin Avenue, is planned to be repaved from Burroughs Drive to Glacier Road as part of a separate project. This project will be bid in April and construction is planned for mid-summer.
Prospect Avenue: (from Main Street to School Street): This project is currently being designed and the extent and timing of utility poles relocations is unknown so no construction dates have been set. As of now, it is more likely this project will occur in 2027.
Paving & Utility Improvements in: Capitol Dr. & W. Wisconsin Ave.
06.23.2025 Update:
The Village Board awarded the 2025 Road and Utility project contract to Payne & Dolan, Inc. on June 17, 2025. The Capitol Drive project will be from 200 feet east of Sussex Street to Clark Street. The W. Wisconsin Avenue project will be from the railroad tracks to Burroughs Drive. The work is anticipated to start in mid-July and substantially completed by October 1, 2025.
Along Capitol Drive, the work includes relay of the water main, catch basin and inlet replacements, spot concrete curb and gutter removal and replacement, spot concrete sidewalk and ADA ramp removal and replacement, and pavement striping. The water services will be replaced from the water main to the curb stop valve box which is near the property line. The proposed reconstruction will include removal and replacement existing asphalt pavement. The existing street width will remain the same as most curb and gutter will remain as is.
Along W. Wisconsin Avenue, the work includes removal and replacement of the asphalt pavement, spot concrete sidewalk removal and replacement, and pavement striping.
During the project, a construction inspector will be onsite to observe construction. You may contact this inspector if you have comments, questions, or concerns with the project.
Parking and Access
Before actual construction starts, the Contractor will be issuing a notice 24-hours in advance to properties along the construction work. After that notice, the utility and street work will begin. Traffic will attempt to be maintained as much as possible during the construction. There may be intermittent times when no access will be allowed depending on what work is being completed. One way traffic is proposed to be maintained by Contractor. Please observe “No Parking” signs to assist the Contractor in getting the work completed.
Water service repairs
The contractor and inspector will coordinate with property owners with more advanced notices regarding short term water outages to businesses and residential homes needed for water main cross over connections and water service replacements.
Garbage and Recycling
During the street reconstruction, Garbage and Recycling collection will continue on the same day that it is usually collected. One way traffic flow will be maintained. Your carts may need to be moved to the end of the street if the garbage truck cannot get through the construction project.
Street Reconstruction
The plan is to preserve as much concrete curb and gutter as possible. The Contractor will attempt to not disturb fences or retaining walls that are located adjacent to the sidewalk. If you have any plantings or landscaping that you want to re-plant please have them removed before the construction begins. Also, you may trim any limbs or bushes that overhang the street. The Contractor will not be responsible for broken branches that overhang into the street.
One way traffic is planned to be maintained during the project. Please do not drive on the new pavement until the barricades have been removed from the entrances. The new street will be opened as soon as possible. The Contractor is allowed a certain number of work days. Keeping the street temporarily closed after the pavement is completed and cured prevents the pavement and concrete driveways from cracking and failing. After the street is open, there may be seeding and miscellaneous work to finish. The schedule of this project will depend greatly upon the weather.
Street and utility reconstruction is a major undertaking. We appreciate your tolerance to the noise, dust, dirt, mud, and the overall inconvenience of reconstruction.
If you are a business owner with employees or customers, property manager or landlord and your property is rented to tenants, please pass along the applicable information from this letter to your employees, customers, or tenants as soon as possible.
06.02.2025 Update:
Orchard Avenue & Park Hill Drive Updates:
12/11/24 Update:
The road project has been completed. Restoration and remaining punch list items should be completed by June 2025.11/01/24 Update:
Paving will begin November 2, 2024, paving on Park Hill and Orchard Ct. Please do not park on the new pavement. 10/21/24 Update:
Orchard Ave. Installation of concrete curb and gutter, sidewalks, handicap ramps and driveway aprons. There will be limited to no access to driveways so please check your doors and mailboxes for notices and durations.
Park Hill Dr.
Water main connections will be installed with daily shut downs, please check doors for notices. Water main services will also be installed, homeowners will be notified of shutdown during connection. Installation of concrete curb and gutter, sidewalks and handicap ramps. There will be a lot of activity this week so please be patient and use alternate routes if feasible.
10/01/24 Update:
Orchard Ave.Water service installations to occur this week. DPW workers will knock on doors to notify residents when water service connections will be made. Homeowners will be without use of water for approximately one hour and notified when back on.
Park Hill Dr. (Oaklawn Ct. to Lakeview Ct.)
Water main installation has finished. Main will be tested this week.
09/23/24 Update:
Orchard Ave.Water Main installation will be tested this week. Residents may experience slight delays, please be patient as the contractor will get traffic through.
Park Hill Dr. (Oaklawn Ct. to Lakeview Ct.)
Water main installation will continue. Please be patient in single-lane traffic work zones.
*Schedule is weather dependent. No parking on roadways in work areas.
09/13/24 Update:
The Pewaukee Road and Utility Improvements Project started this week with water main work on Park Ave. and continuing down Orchard Ave Alley. Your patience and understanding is appreciated with the partial closure on Park Ave. It will be paved and reopen before the weekend.
Anticipated Construction Projects:
- Mill and re-pave of Concord Road and Meadow Creek Court
- Pulverize and pave of Hickory Street east of Forest Grove
- Removal and repaving of the alley between Hickory and Oakton
- 1010 Quinlan water reservoir rehabilitation
- Kopmier Drive sanitary lift station replacement
- Repaving of Savoy Ct
Anticipated Construction Projects:
- Stone Ct, Briar Ct, Timber Ridge, and Lexington Ct - mill and overlay
- East Wisconsin Ave - street and utility reconstruction (Due to start August 1st)
Replace water main relay on Evergreen Lane
- Replace the 1950's cast iron water main with a modern 6" pipe
Park Hills Sanitary Relay
- Sanitary sewer project will be in the easement located east of the Cheshire and High Street intersection
- Replace the existing 8" pipe with a 12" pipe to accommodate existing and future wastewater flows
- Replacing 1,152 feet
